Getting started

Quick start

One simple project in eight steps: your rate, the first entry, the Time page, budget health and the effective rate, out-of-scope work, and a client report.

Last updated

Eight steps through Phased with a real job of your own, or a made-up one you can delete afterwards. A new account starts with 30 days of Pro, so every step is open to you from the first sign-in.

1. Check your rate and currency

During setup, Phased asks for the default client rate and display currency. The rate gives your tracked time a value. You can change both later under Settings › Rates & currency.

Use the hourly rate you normally charge, or the rate you want to earn. A project or phase can have its own rate, but Phased always needs this one to fall back on.

2. Create a simple project

  1. Open Projects and press New project.
  2. Give the job a name. Keep Simple if the whole job has one rate and one budget.
  3. If you want, choose a client or create a new one.
  4. Add an optional budget in money or hours, check the rate below it, then press Create.

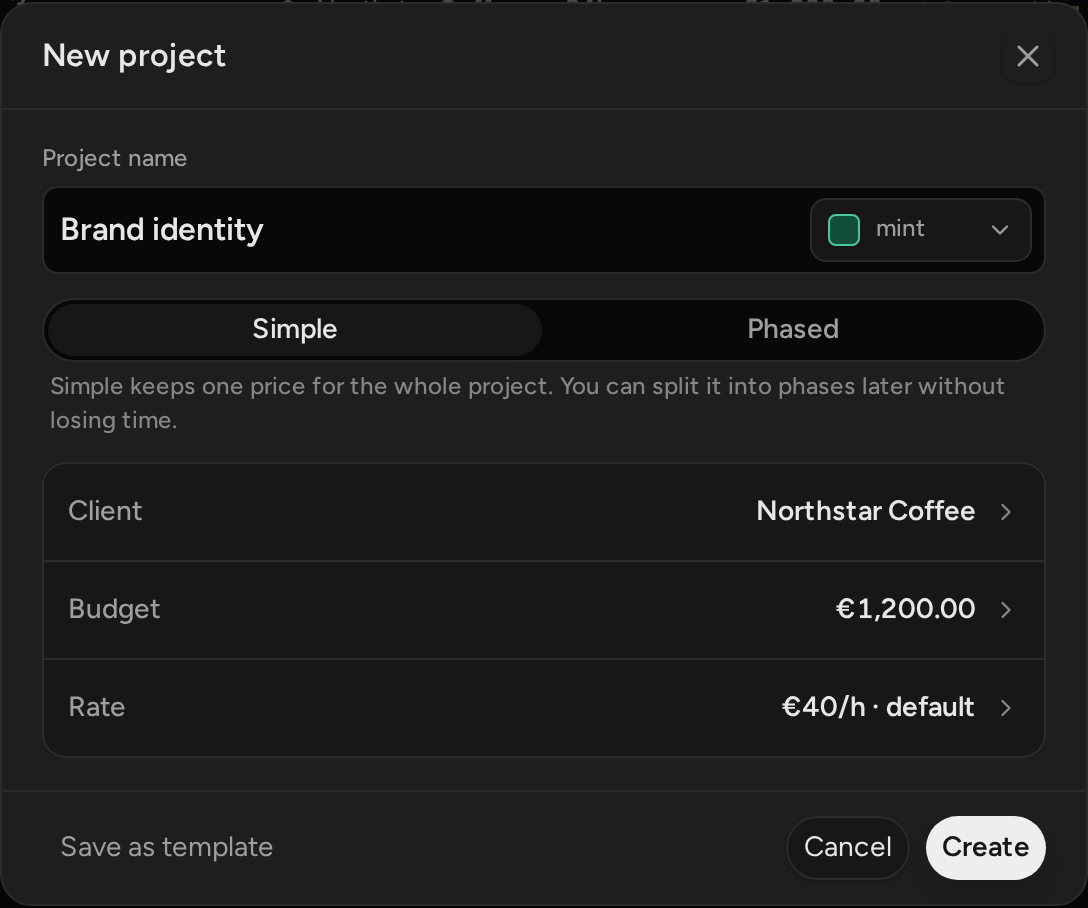

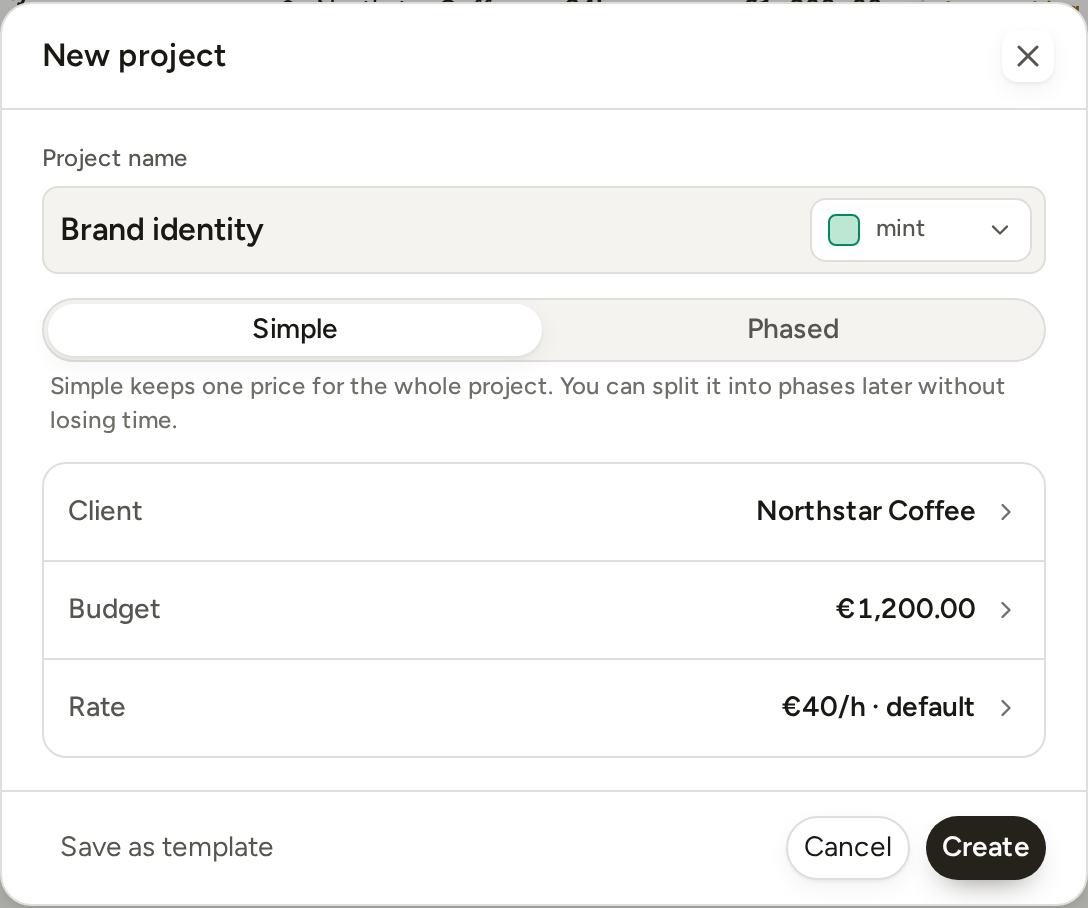

The New project form filled in: Brand identity, Simple selected, client Northstar Coffee, budget €1,200, rate €40/h from your workspace default, with the Create button. The New project form filled in: Brand identity, Simple selected, client Northstar Coffee, budget €1,200, rate €40/h from your workspace default, with the Create button.

A money budget is the price you agreed for the work. An hours budget is the time you planned, and Phased works out its money value from your rate. For ordinary hourly work, leave the budget empty.

3. Track the first piece of work

Open Calendar and drag over the time you worked. The entry panel opens with that length already set. Choose the project and press Add.

There are two other ways to add time. The + opens a 15-minute entry at the current time, which you can then adjust. The timer tracks work you are doing now: choose a project and start it. Every entry belongs to a project and a phase. On a simple project, Phased handles the phase for you.

4. Name and correct the entry

Select the entry to change its day, times, duration, project or phase. Add a task to name the work, and use the note for private detail you may want in an internal report. Next time, start typing in the note of a new entry. Phased lists your earlier entries, and choosing one fills in the note, project, phase and task.

An entry open for editing beside its calendar block: the note, the project, a task, and its start, end and duration. An entry open for editing beside its calendar block: the note, the project, a task, and its start, end and duration.

The task control offers your saved names. If you type a new name, choose the create row to add it as a task. Drag the block to move it, or resize it from either edge. Hold Alt while you drag to copy it instead. To split one block into two, shorten the entry and draw a second one.

5. Review where the time went

Open Time to choose a date range and see total time, the average across days worked, the value at your rates, and Out of scope time. The chart shows when you worked and divides the hours by project.

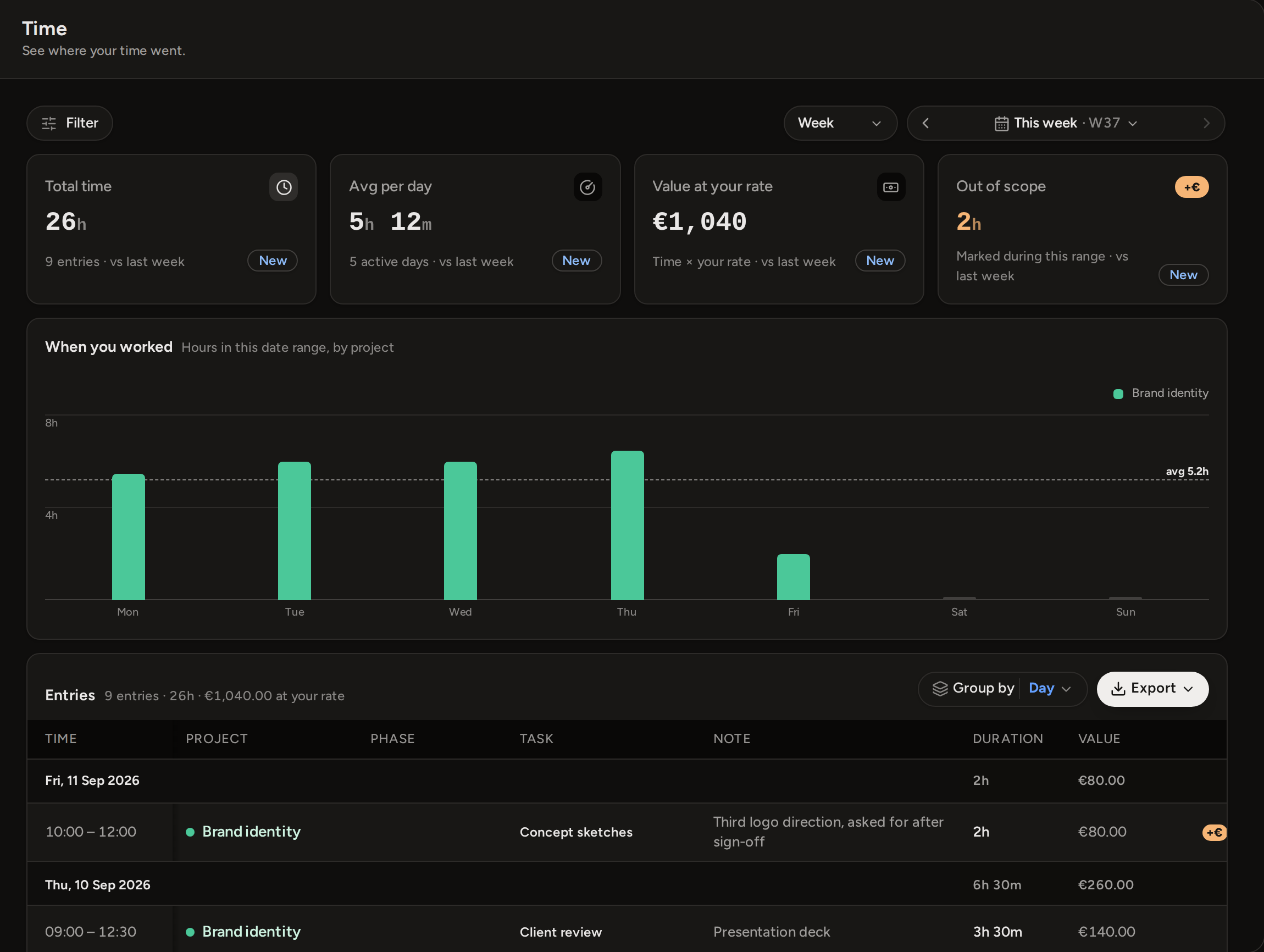

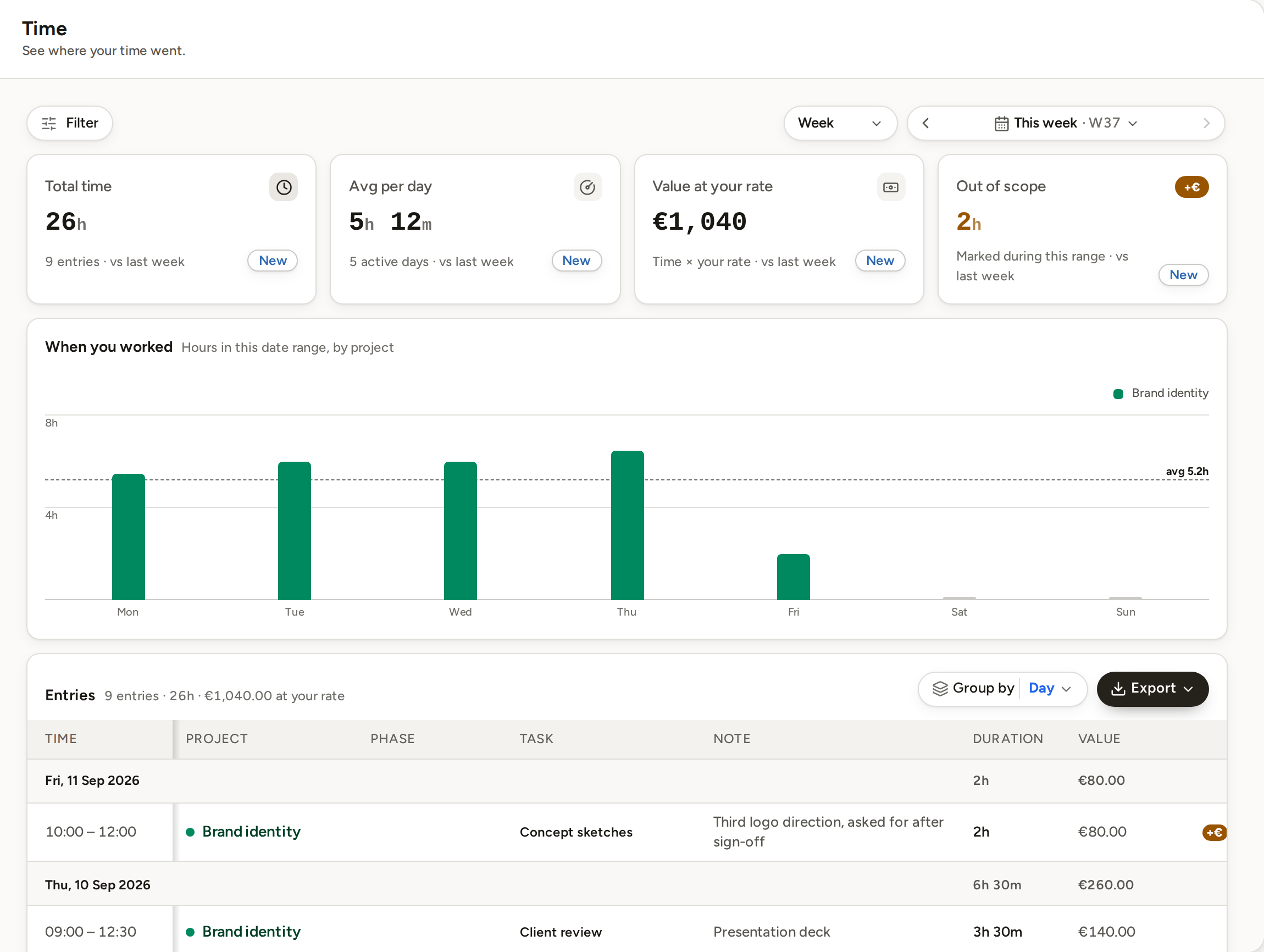

The Time page for one week: 26 hours over 9 entries, €1,040 at your rate, 2 hours out of scope, a bar chart by weekday, and the entry table grouped by day. The Time page for one week: 26 hours over 9 entries, €1,040 at your rate, 2 hours out of scope, a bar chart by weekday, and the entry table grouped by day.

Filter by client, project, phase, task or scope, then group the entry table by day, project, client or phase. The CSV export follows the range and filters currently on screen.

6. Read the budget and effective rate

Open Profitability and find the project under Budget performance. A budget never stops time tracking. Budget health compares the time spent on the agreed work with the time the price covers at your rate. Below 80% is On track, 80% to 100% is Approaching, and above 100% is Over budget.

Budget performance for Brand identity: 24 hours logged against a €1,200 budget, 80% and Approaching, €240 and 6 hours left, 2 hours out of scope, target €40 an hour, effective €50 an hour. Budget performance for Brand identity: 24 hours logged against a €1,200 budget, 80% and Approaching, €240 and 6 hours left, 2 hours out of scope, target €40 an hour, effective €50 an hour.

The effective rate is the agreed price divided by the hours tracked on the agreed work so far. In the picture, €1,200 over 24 hours is €50 an hour, which is above the €40 rate. The 2 out-of-scope hours are not counted. The rate changes as you log more time, and is final when the work is done.

7. Mark extra work as Out of scope

If the client asks for work outside the agreement, open only those entries and turn on the Out of scope switch. The switch shows once the project or phase has a budget. The entries stay in your records, but they no longer count towards the original budget. You can price this work separately as Additional Work on a Phase or Project Report.

An entry marked Out of scope: the Out of scope switch at the end of the task row is on. An entry marked Out of scope: the Out of scope switch at the end of the task row is on.

8. Create a report and keep tracking

Use a Time Report for a date range, a Phase Report for one phase, or a Project Report for several phases or the whole project. Open the saved report to check it, then download the PDF and share it outside Phased.

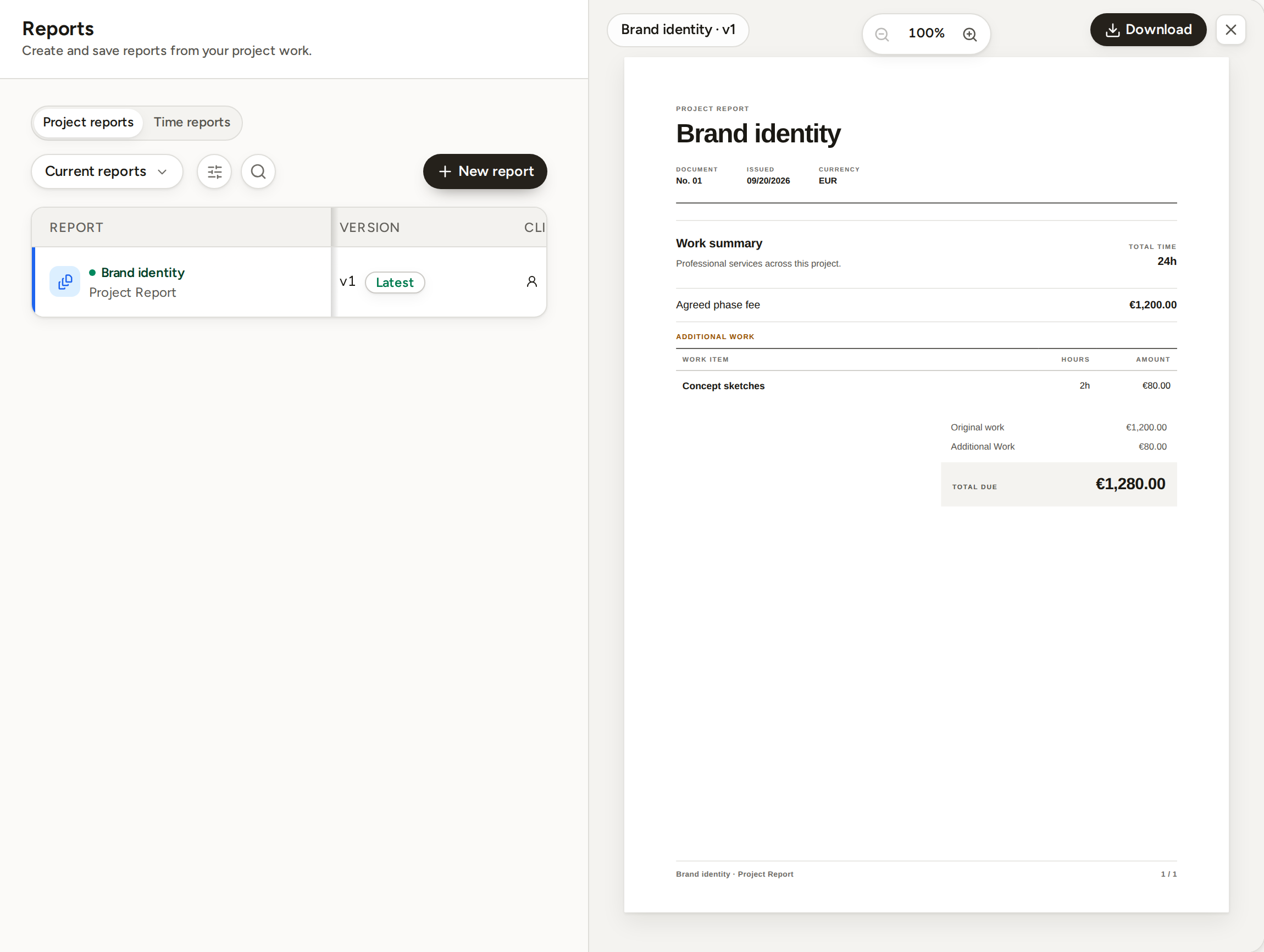

The Reports page with a saved Project Report open beside its row: the document's first page with the work summary, the agreed fee, the Additional Work line and the total, and a Download button. The Reports page with a saved Project Report open beside its row: the document's first page with the work summary, the agreed fee, the Additional Work line and the total, and a Download button.

A saved report keeps its figures. If you edit entries later, the report does not change. If this was only practice, delete the report, then delete the project. Phased tells you how much time is deleted with it. A Phase Report also marks its phase Reported, so first choose Mark unreported on that phase. To keep a finished project's history, archive it. To reuse a setup for the next job, save it as a template.

To read more about these steps, see Time entry, Out of scope and Free and Pro.
